• 20 September 2024
    Eco friendly container vessel calling at Baltic Container Terminal

    Xpress Feeders’ first eco-friendly container vessel, Eco Umande, called at Hili Company’s container terminal in Latvia, Baltic Container Terminal on the 18th September 2024.

    The vessel is equipped with dual-fuel engines capable of running on both conventional fuel and green methanol. X-Press Feeders uses OCI Global green methanol, which is ISCC EU (International Sustainability and Carbon Certification) certified and reduces greenhouse gas emissions by up to 65%. The vessel is also equipped with a shore-side power supply system, allowing for further emission reductions while docked at ports and terminals.

    12 September 2024
    Commencement on works on yard extension at Baltic Container Terminal

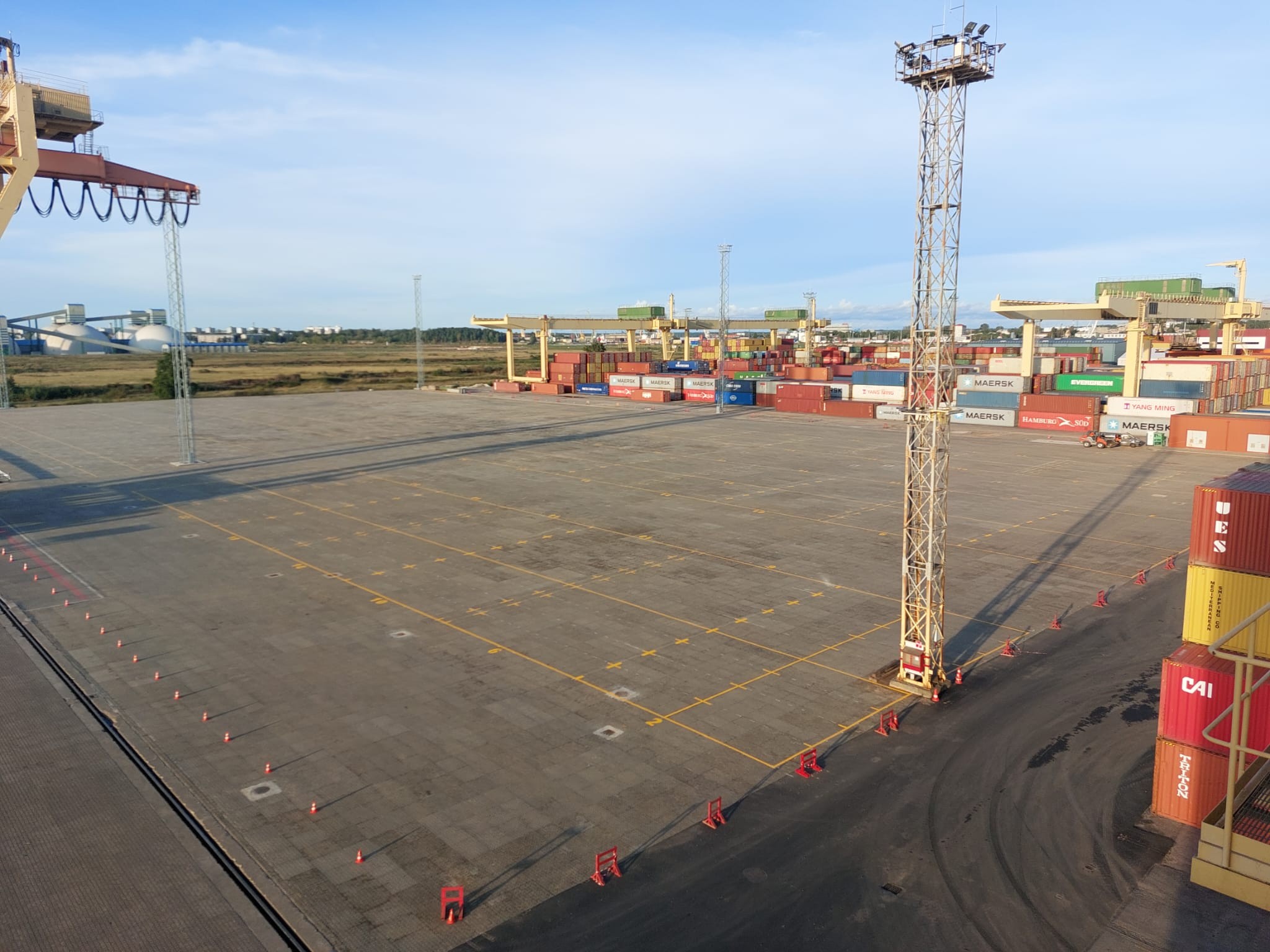

    Works on the yard extension at Hili Company’s container terminal in Latvia, Baltic Container Terminal, have commenced. The terminal is extending its container stacking area by 29,600 square metres. Works are envisaged to be complete by August 2025.

  • 06 June 2024

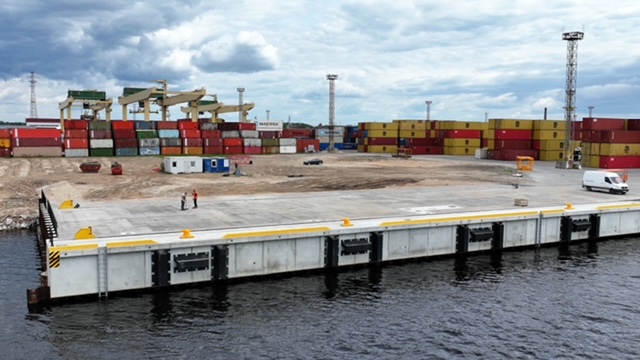

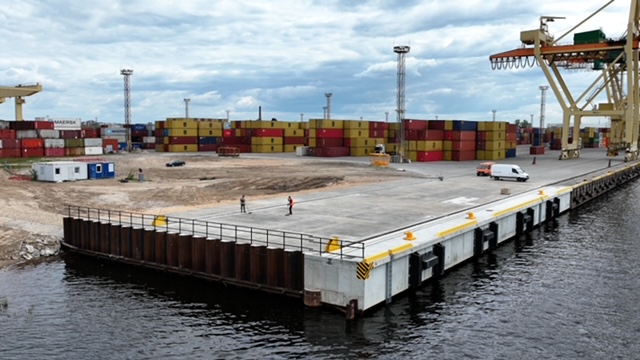

    Quay extension at Baltic Container Terminal has been completed and commissioned.

    The construction of the Baltic Container Terminal berth KS-34 has been completed and commissioned by City Development Department of Riga City Municipality on June 5th 2024.

    After extension the total length of the quay is 506,3 meters, which allows mooring of ships whose length reaches 340 meters and serve simultaneously two large container or military vessels. Extension also significantly improves the quality of services and speed up operations provided by the Baltic Container Terminal.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.”

    18 March 2024
    Quay extension at Baltic Container Terminal is nearing completion

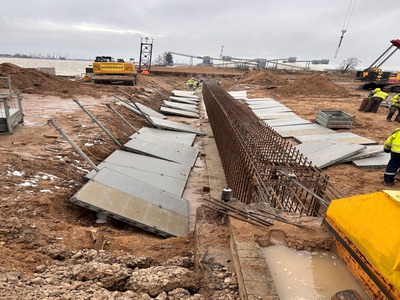

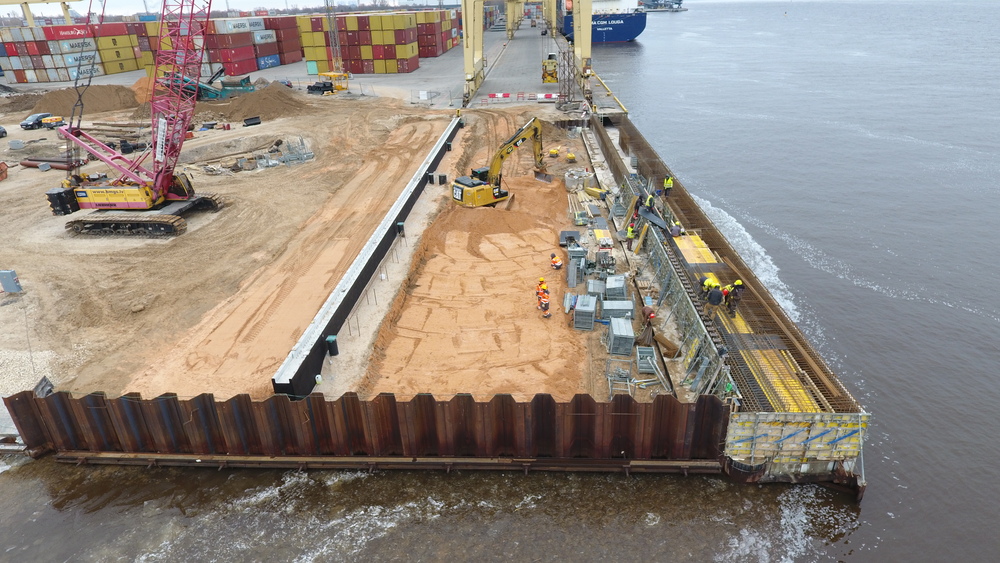

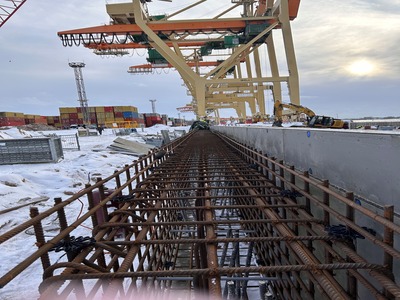

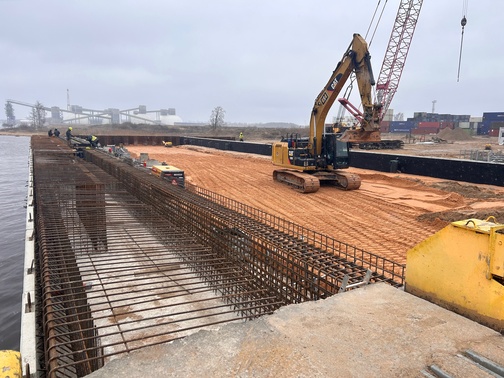

    The construction of the Baltic Container Terminal berth KS-34 has been completed by more than 85% and are nearing completion. The construction of the ground side rail base of the crane has been completed and rain drainage networks have been built. Concreting works of the quay superstructure is underway. The preparation of the base for the construction of the pavement of the quay has been started.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.”

  • 22 January 2024
    Works progress on quay extension at Baltic Container Terminal

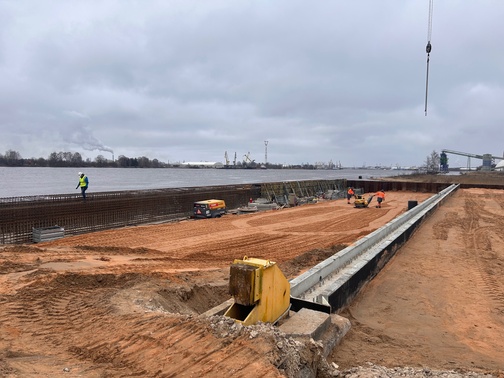

    Despite the winter conditions – snow storms and low temperatures, the construction of the Baltic Container Terminal berth KS-34 is progressing.

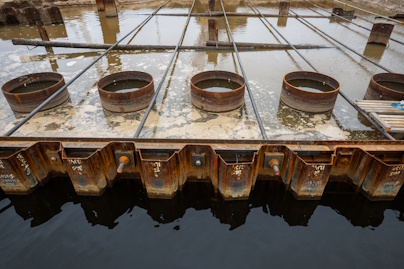

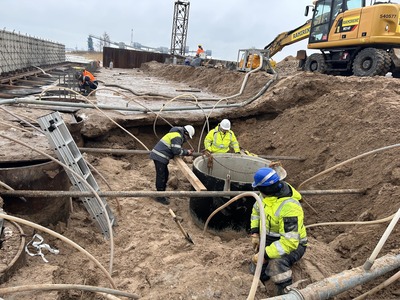

    47 reinforced concrete piles of length of 16 meters have been driven in for base of crane rail beam.  Static loading of two reinforced concrete piles was carried out to verify their bearing capacity. The reinforced concrete formwork of the superstructure facade has been completed and installation of rainwater drainage wells and reinforcement and molding of the crane rail base beam is underway.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.

    03 November 2023
    Works progress on quay extension at Baltic Container Terminal

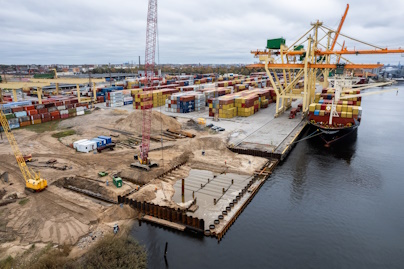

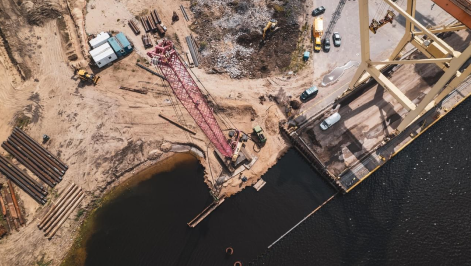

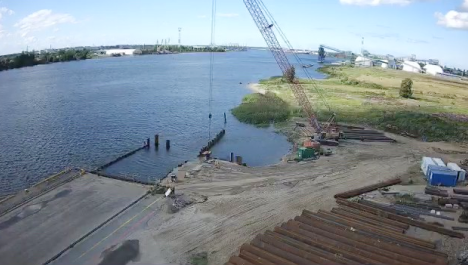

    The construction of the Baltic Container Terminal berth KS-34 is progressing as per schedule - underwater section of the construction works is coming to the completion.

    280 grooved piles with a length of up to 23.15 meters have been installed, 24 pipes with a length of 21.8 meters have been driven in, and the work of strengthening the anchors of the quay and adding sand in the quay body is nearing completion.

    The progress of the quay construction was also briefed to the National Armed Forces (NAF) representatives from National Defense Academy (NDA), which visited the terminal on November 2nd, 2023 as part of a planning Course for NAF and allied officers. During the visit, terminal capacity and ability to promote military mobility were discussed.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.”

  • 12 September 2023
    Hili Company commissions Solar Park

    Hili Company's container terminal in Latvia, Baltic Container Terminal have commissioned a solar park over the rooftop of one of its warehouses. Spread over 11,600 sqm, the Solar park consists of 1,974 solar panels with a capacity of 1.1MW.

    04 August 2023

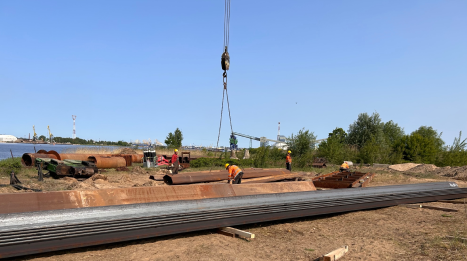

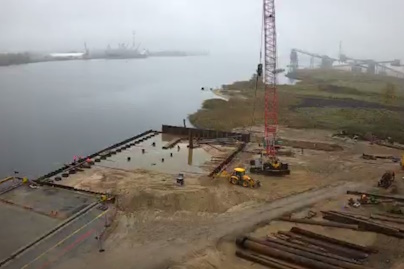

    Works on quay extension at Baltic Container Terminal

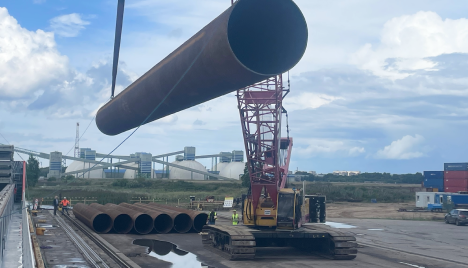

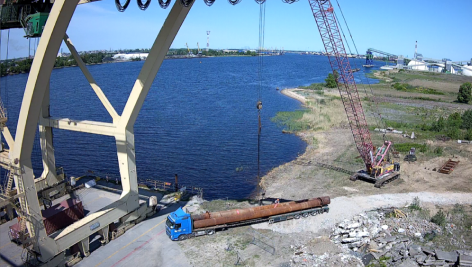

    The active phase of the construction of the Baltic Container Terminal berth KS-34 has been started. The metal pipes that form the base of the quay crane rails have been delivered, and part of the sheet pile quay wall has also been built.

    After extension the total length of the quay will be 506,3 meters, which will allow mooring of ships whose length reaches 340 meters and serve simultaneously two large container/ ro-ro or military vessels.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.”

    See also: https://rop.lv/en/news/reconstruction-kundzinsala-bridge-has-been-completed-improve-military-mobility

  • 19 July 2023
    Construction of a new warehouse at Hili Company’s container terminal in Latvia.

    Construction on the new 1,400sqm warehouse at Baltic Container Terminal, Latvia is well under way. Works are expected to be completed in August 2023. This increases the terminal's warehousing capacity to a total of 37,000m².

    29 May 2023
    Commencement on works on quay extension at Baltic Container Terminal

    Works on the quay extension at Hili Company’s container terminal in Latvia, Baltic Container Terminal, have commenced. The quay will be extended by 57m thus bringing the total quay length to 506m.

    The extension, which will allow for servicing two large vessels simultaneously, will also significantly speed up operations at the terminal.

    This project is partly being 50% co-financed by the European Climate, Infrastructure and Environment Agency (CINEA) military mobility project. This is being carried out in conjunction with Riga Freeport Authority under project objective of “Enhancement of the Dual Use Capacity of Riga Port by investment in Road, Railway Access and Berth Infrastructure.”

    See also: New projects to strengthen competitiveness and promote military mobility in the Port of Riga
